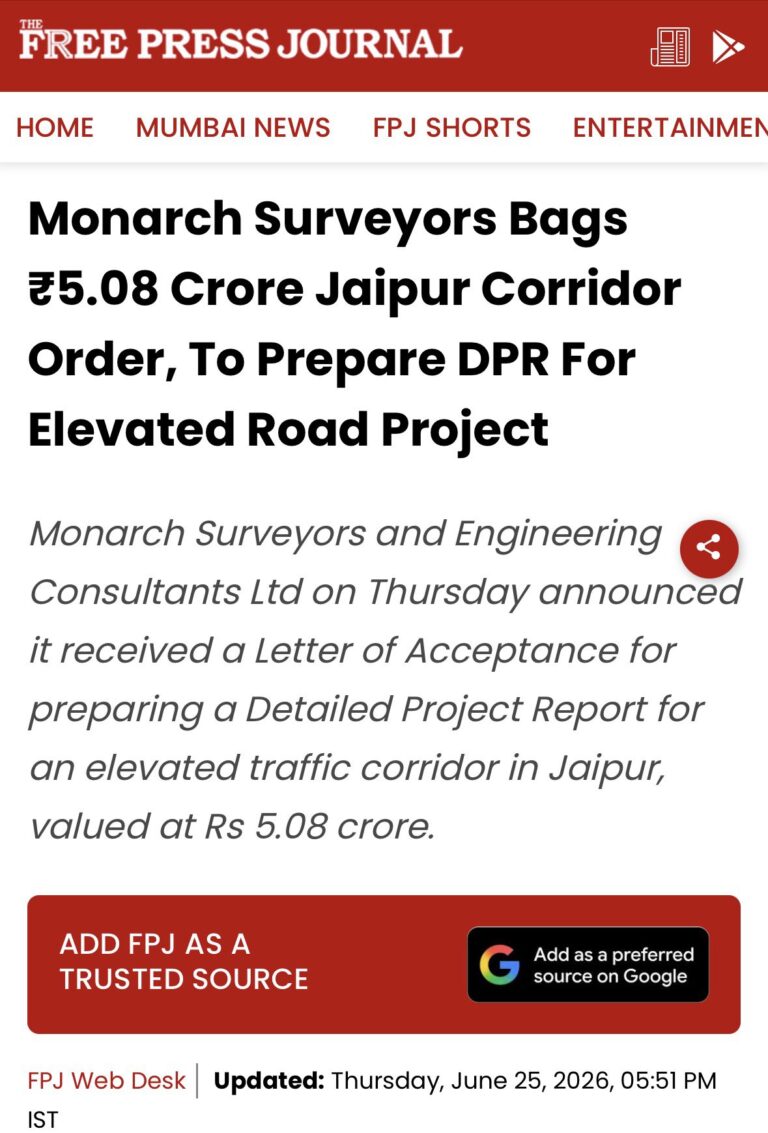

After the โ‚น100 Crore Waste on the Seven Wonders at Ajmerโ€™s Ana Sagar Wetland, Is โ‚น5,000 Crore Now at Stake on the Elevated Road Over Jaipurโ€™s Dravyavati River?

0

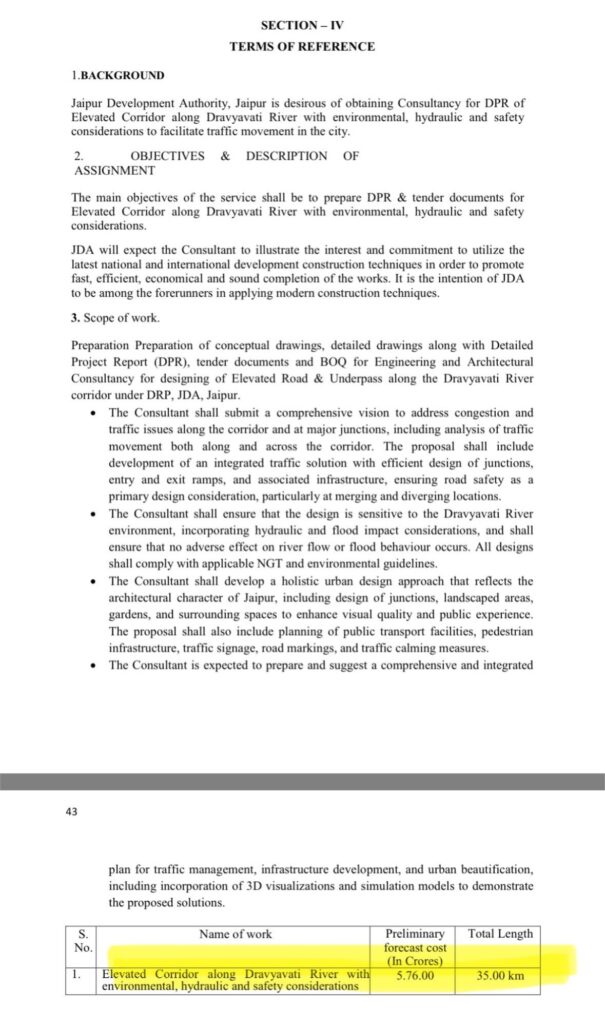

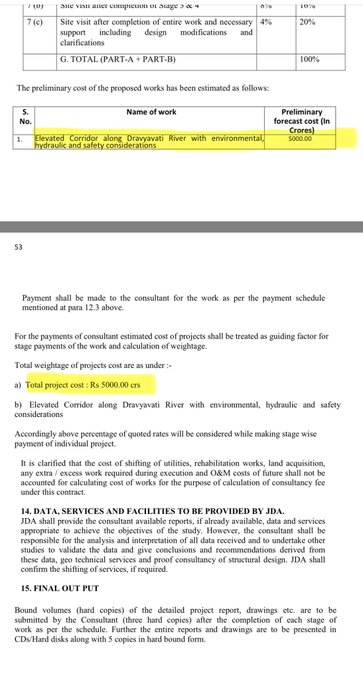

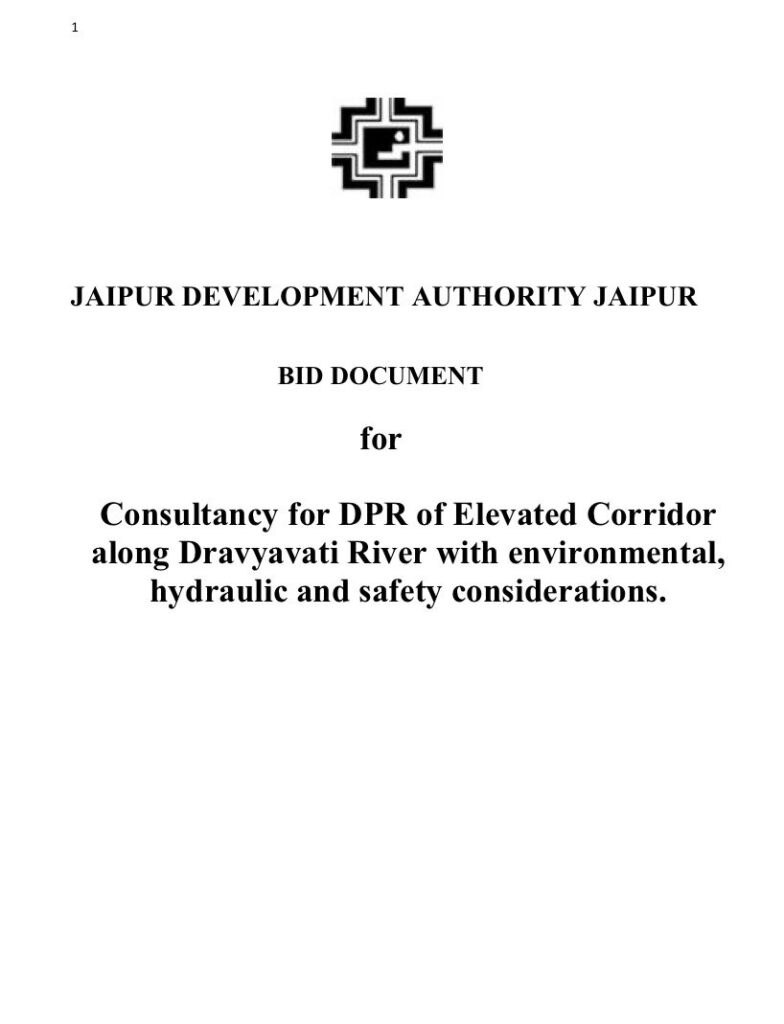

The Seven Wonders Park built in Ajmerโ€™s Ana Sagar Wetland cost approximately โ‚น100 crore, and it had to be removed following a court order. Now, in Jaipur, a project for a nearly 35โ€“36 kilometer-long elevated corridor along the Dravyavati River, costing around โ‚น5,000 crore, is being advanced. For this, the JDA has awarded a โ‚น5.08 crore contract to Monarch Surveyors to prepare the DPR.

The most important point is that the tender document itself states that the project must not violate NGT guidelines and should not adversely affect the natural flow of floods. This makes it clear that the JDA is fully aware of the legal and environmental sensitivities of this project.

Yet the question arises: When the Supreme Court and various judicial decisions have consistently adopted an extremely cautious stance regarding permanent construction in catchment areas and floodplains, why is a new โ‚น5,000 crore project being proposed in such an area?

The Dravyavati River itself is already the subject of judicial disputes. The โ‚น1,676 crore Dravyavati River Rejuvenation Project is under the supervision of the Rajasthan High Court. In 2024, the Jaipur Bench had clearly stated that โ€œthe right to live in a clean environment is a fundamental rightโ€ and directed the JDA to submit regular compliance reports. Additionally, the dispute over whether the land for the river embankment is government or private is still pending in court. In such a situation, initiating a new elevated road project in the same disputed corridor raises several new legal questions.

In M.C. Mehta vs. Kamal Nath (1997), the Supreme Court recognized the Public Trust Doctrine and stated that the state does not own rivers, forests, and other natural resources but holds them as a trustee, and they cannot be arbitrarily altered in the name of development projects.

Similarly, the NGT has consistently reiterated in various casesโ€”Yamnuna (Manoj Mishra case), Ganga, Mansi River, and the recent Panjra River caseโ€”that construction in floodplains cannot be justified merely on the grounds of โ€œpublic interestโ€ or โ€œpublic utility.โ€

In the context of the Wetland Rules, 2017, and the Environmental Impact Assessment (EIA) Notification, 2006, it is also a crucial question whether environmental clearance will be mandatory for such a large linear infrastructure project.

The Seven Wonders Park case is an important example in this context. In 2023, the NGT ordered the removal of the park on the grounds of wetland and master plan violations. The state government argued in the Supreme Court that crores of rupees had already been spent on the project, so it should be allowed to remain. But on March 18, 2025, the Supreme Court rejected this argument and clearly stated that the destruction of the wetland is akin to โ€œinviting disaster.โ€ Ultimately, the entire structure had to be demolished in September 2025.

In such a scenario, it is natural to question whether the government is once again preparing to spend thousands of crores on a project carrying similar legal risks? If the court issues an adverse decision on this project in the future, who will bear the financial and environmental responsibility?

Jaipur’s Government Land Worth โ‚น1000 Crore Exposed in Settlement Fraud Scandal!

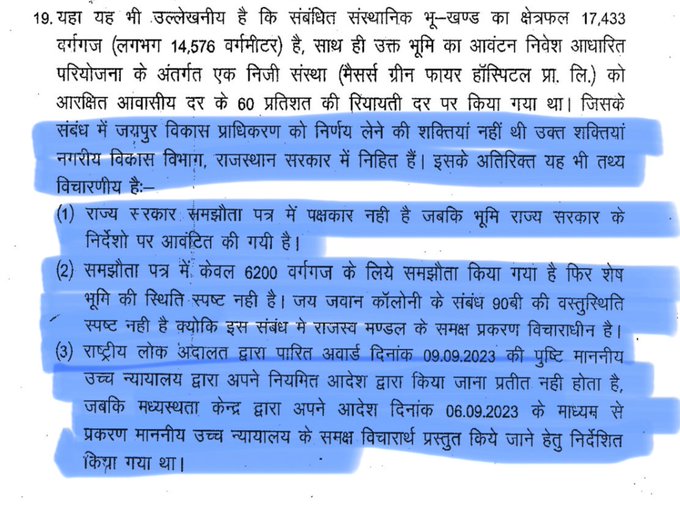

0

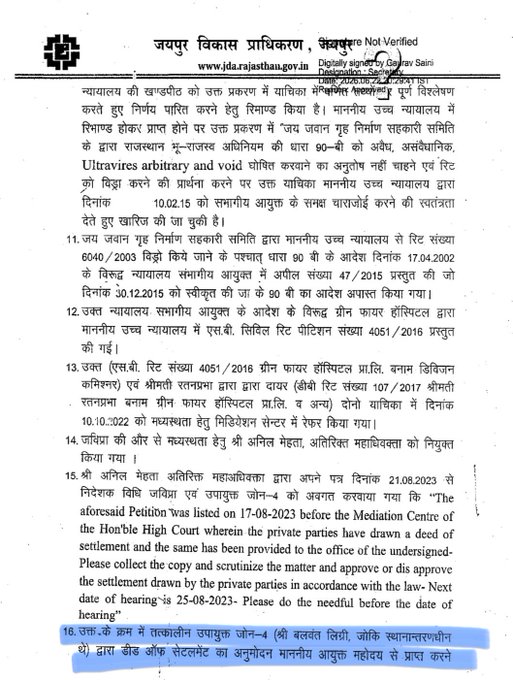

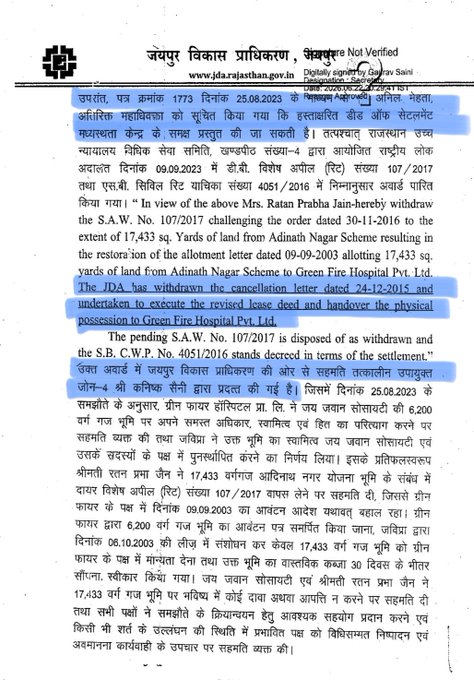

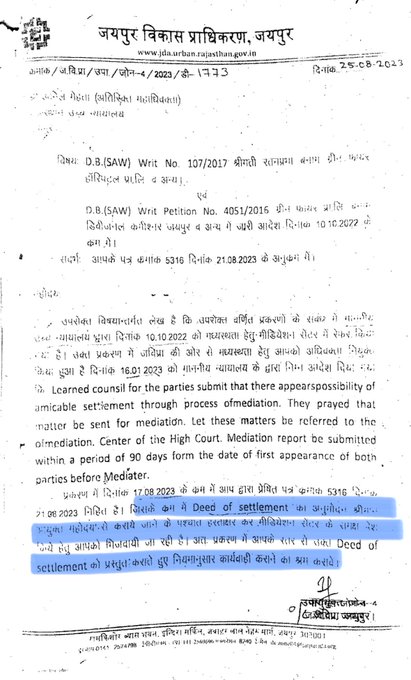

The Rajasthan government has itself approached the High Court regarding the 23,600 square yards of prime land right opposite World Trade Park (WTP) on JLN Marg, with allegations that JDA officials colluded to keep the government in the dark. What is the case? In 2003, this land was allotted to Green Fire Hospital Pvt. Ltd. at a concessional rate to build a multi-specialty hospital. In 2015, the allotment was canceled due to violation of conditions, and the money was also refunded. But in 2023, a sudden “settlement” took place, and the National Lok Adalat passed such an award that revived the already canceled allotment. 17,433 square yards of land back to Green Fire Hospital 6,200 square yards of land to Jai Jawan Grih Nirman Sahakari Samiti and Ratan Prabha Jain Government’s Allegations No approval from the Cabinet was taken The UDH department was not informed No authorized representative of the government was involved in the agreement The government claims that the then JDA Commissioner and Zone-4 DC had no legal authority to enter into such an agreement, yet private parties were directly benefited. The shocking part is that the Lok Adalat did not even verify whether the necessary parties (especially the state government) were involved in the agreement or not. How did the government get wind of it? In 2026, when Green Fire Hospital filed a contempt petition for non-compliance with the award, that’s when the government dug into the records, and the entire game came to light. Allegations are that information about pending cases was concealed, incomplete facts were presented, and efforts were made to suppress the investigation by hastily withdrawing the JDA Tribunal case. The High Court has ordered the preservation of all records. The joint hearing of the contempt petition, both public interest litigations, and related cases is scheduled for July 20.
